Job Cost · Included in Twinn Reports

Job Performance (WIP) for Sage 100 Contractor

The work-in-progress schedule your bank, bonding agent and CPA ask for, without rebuilding it in Excel every month. Every job, its revised contract and estimate, cost to date, percent complete, earned revenue, over or under billing and backlog, as of any date you pick.

It runs in your browser against your live Sage 100 Contractor data, through the Twinn service on your own network, and exports to Excel, PDF or CSV.

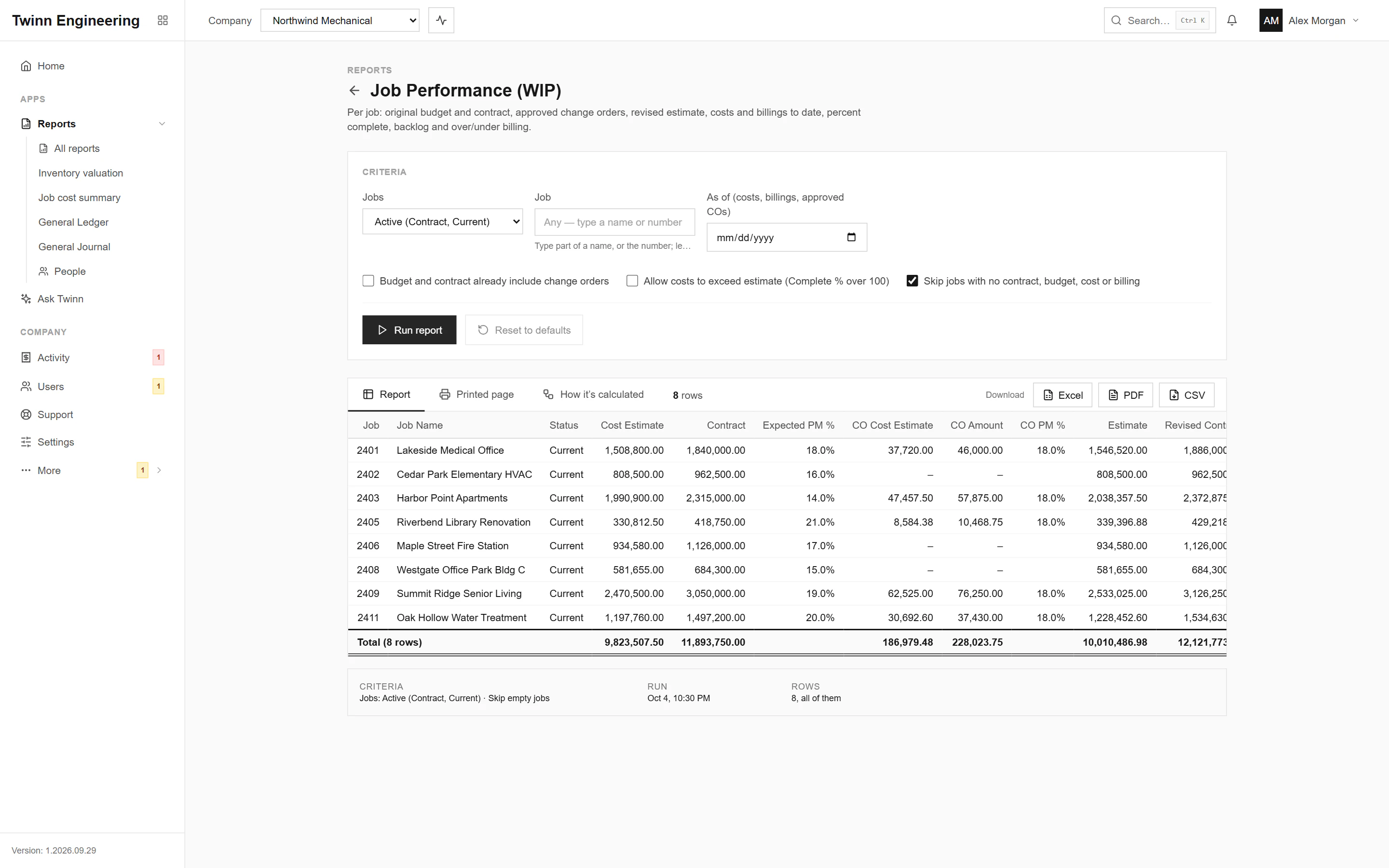

Job Performance (WIP) running in Twinn Reports
Job Performance (WIP) in Twinn Reports. Shown on a demo company; every name and number is made up.

Who uses it

  • Controllers closing the month
  • CFOs and owners preparing for the bank or surety
  • Project managers checking their jobs

The questions it answers

  • Which jobs are overbilled, and by how much?
  • What is our backlog going into next quarter?
  • Which jobs are tracking below the margin they were bid at?
  • What did the WIP look like at the end of last quarter?

Ask Twinn · Early access

“Show me the WIP schedule as of the end of last month.”

Ask Twinn, the assistant inside Twinn, runs this same report to answer questions in plain English. It tells you which report it ran, with which criteria, as of when, so the answer always matches the report.

How Ask Twinn works

What’s in the report

Every column, and what it means.

Job
Job number.
Job Name
Job name.
Status
Job status.
Cost Estimate
Job budget.
Contract
Contract amount on the job.
Expected PM %
Margin the job was set up with.
CO Cost Estimate
Budget of approved prime change orders.
CO Amount
Approved amount of approved prime change orders.
CO PM %
Margin on the approved change orders.
Estimate
Revised cost estimate.
Revised Contract
Contract with approved change orders.
Revised PM %
Expected margin after change orders.
Costs to Date
Job cost posted (to the as-of date).
Billings to Date
Amount billed (to the as-of date), retention included, sales tax excluded.
Current PM %
Margin so far on a billed basis.
Cost to Complete
Estimate still to spend; negative when costs have passed it.
Complete %
Percent complete by cost.
Earned Revenue
Revenue earned by the work done.
Backlog
Contract not yet billed.
Over/Under Billed
Positive = billed ahead of the work (overbilled); negative = work not yet billed (underbilled).
Billings This Year
Billings dated in the calendar year of the as-of date (this year when blank), up to the as-of date.

Criteria you can set

Pick these before you run it. Twinn remembers your last run.

  • Jobs
  • Job
  • As of (costs, billings, approved COs)
  • Budget and contract already include change orders
  • Allow costs to exceed estimate (Complete % over 100)
  • Skip jobs with no contract, budget, cost or billing

How it’s calculated

The same notes Twinn shows beside the report, so anyone reading it knows what the numbers include.

  • Cost Estimate is the job budget. Approved prime change orders add their budget (CO Cost) and approved amount (CO Amount). Tick 'Budget and contract already include change orders' if your company posts approved COs into them, otherwise they're counted twice.
  • Complete % = Costs to Date / Estimate (capped at 100% unless you allow costs to exceed the estimate). Earned Revenue = Revised Contract x Complete %.
  • Over/Under Billed = Billings - Earned Revenue: positive means overbilled (billings in excess of earnings), negative means underbilled.
  • Billings exclude void invoices and sales tax. Costs are open job cost records. With an as-of date, costs, billings and approved change orders (by Approved date) are cut off at that date; leave it blank for everything posted.
  • Backlog + Billings This Year gives the workbook's 'Backlog + YTD' figure.
